1. Project Snapshot
An early-1970s, 11-unit apartment complex perched on a gentle hillside in Northeast Los Angeles sought to unlock under-used land without sacrificing tenant parking or the prized skyline sight-line toward downtown. Leveraging California’s new Senate Bill 1211 (effective Jan 1 2025), the owner received ministerial approval to site eight identical, steel-framed 1-bed/1-bath accessory dwelling units (ADUs) behind the existing structure. Each 520 sq ft unit mirrors its neighbor, enjoys a covered balcony, and is assigned one surface parking stall. The project keeps the complex’s “soft-story” podium intact, adds no height to the main building, and gives every new resident a panoramic downtown view.
2. What SB 1211 Changes
Until now, multifamily owners could build only two detached ADUs. SB 1211 raises that ceiling to a maximum of eight detached ADUs, so long as the number of ADUs does not exceed the existing unit count on the lot — a perfect match for an 11-unit site. The bill also bans local agencies from requiring replacement parking when surface spaces are converted or displaced for new ADUs and restricts cities to objective design standards; discretionary design review is off the table. (California YIMBY, ezplans.com)
3. Site & Feasibility Analysis
The 20,000 sq ft parcel includes a rear asphalt lot once striped for 18 uncovered stalls. A feasibility pass confirmed:

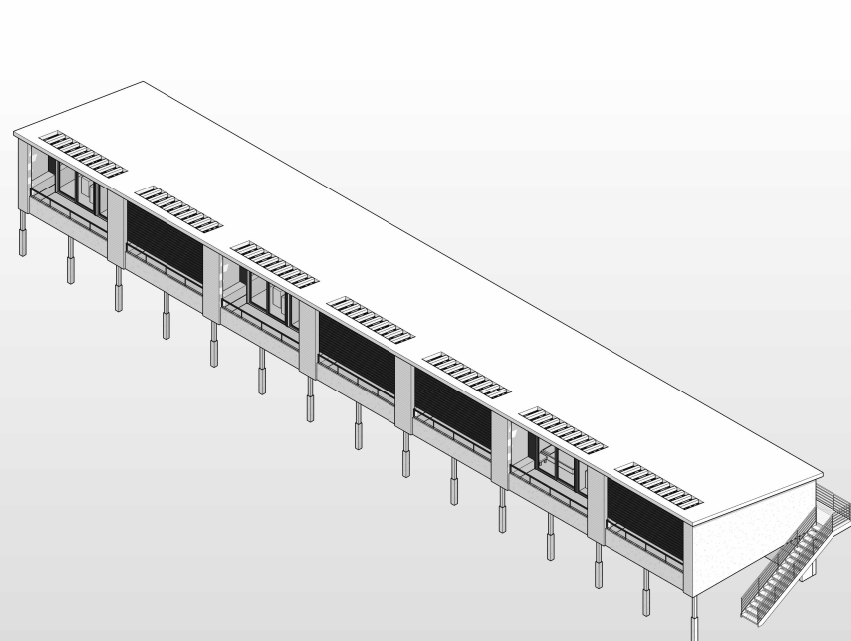

4. Design Solution
Architects opted for mirror-image modules to speed fabrication and simplify inspections. Key features:

5. Parking & Circulation
Thanks to SB 1211’s parking waiver, no replacement stalls were required when eight surface spaces were reassigned. Instead of demolishing these stalls, the team preserved asphalt sub-base, poured new stem walls, and pinned steel columns directly into the existing footing grid. A one-way loop drive now threads between original carports and the new units, preserving emergency-vehicle clearance and ADA access.
6. Permitting Pathway
Because SB 1211 requires cities to process qualifying ADUs ministerially, Los Angeles Planning routed the package through a single-counter “Expedited ADU” desk. Objective checks included:
Total processing time: eight weeks from initial submittal to RTI (“ready-to-issue”) plans—half the duration quoted for a conventional discretionary site-plan review before SB 1211.
7. Construction & Schedule
All eight units were prefabbed as “flat-pack” steel kits, craned into place over four consecutive weekdays. The repetitive footprint allowed:
From site mobilization to certificate of occupancy, the build lasted approximately five months—even with a fall rainy-season start—thanks to parallel interior finish crews.
8. Resident & Community Benefits
9. Lessons Learned
10. Summary
This Los Angeles project shows how SB 1211 unlocks “missing-middle” density on under-utilized multifamily lots. By combining ministerial approvals, a parking-space waiver, and the right modular steel design, the owner delivered eight comfortable, seismically robust homes without displacing existing tenants or overwhelming the neighborhood fabric. As cities grapple with housing shortages, the success of this hillside complex underscores SB 1211’s potential: gentle, elegant infill that slots seamlessly into the urban mosaic while giving residents—new and old—front-row seats to the iconic Los Angeles skyline.
